Concrete Sealing vs Waterproofing: What’s the Difference?
Concrete sealing protects surfaces from absorption and stains, while concrete waterproofing creates a pressure-resistant barrier against groundwater — two fundamentally different services for different problems.
What Concrete Sealing Does (and Doesn’t Do)
Concrete sealers form a surface barrier — either film-forming (acrylic, polyurethane) or penetrating (silane, siloxane) — that blocks water absorption, stains, UV damage, and efflorescence on horizontal surfaces like driveways, patios, and garage floors. A quality sealer typically lasts 1–5 years depending on type and exposure; film-forming types on driveways with direct sun may need reapplication every 1–3 years, while penetrating sealers on shaded patios can stretch to 5 years. What a sealer cannot do is stop hydrostatic pressure — water pushing through a slab or wall from below. A sealed driveway still needs proper grading and drainage; if water pools against the foundation, the sealer alone won’t prevent a leak.
What Concrete Waterproofing Does
Concrete waterproofing creates a continuous membrane — sheet (Bituthene), liquid-applied (MasterSeal 3400), or cementitious (SikaTop 107) — that resists hydrostatic pressure, stopping liquid water from passing through foundation walls and slabs even when groundwater pushes against them. Waterproofing systems last 10–25 years and cost $5–$15 per square foot installed, but they require proper surface preparation and drainage to perform; skipping either step causes 60% of callbacks in NYC brownstone work.
When to Choose Sealer vs Waterproofing
| Factor | Concrete Sealer | Concrete Waterproofing |
|---|---|---|
| Purpose | Surface protection against absorption, stains, UV | Pressure-resistant barrier against groundwater |
| Best for | Driveways, patios, garage floors (horizontal) | Foundation walls, basements, slabs (vertical/below-grade) |
| Hydrostatic pressure resistance | None | Yes — stops water under pressure |
| Lifespan | 1–5 years (varies by type and exposure) | 10–25 years (membrane systems) |
| Cost per sq ft | $0.50–$2.00 | $5–$15 |
| Can fix a leaking basement? | No | Yes |
Best Concrete Waterproofing Method for a Basement
The best method comes down to foundation type, whether you can access the exterior, and if the leak is actively flowing — here’s how the options compare.

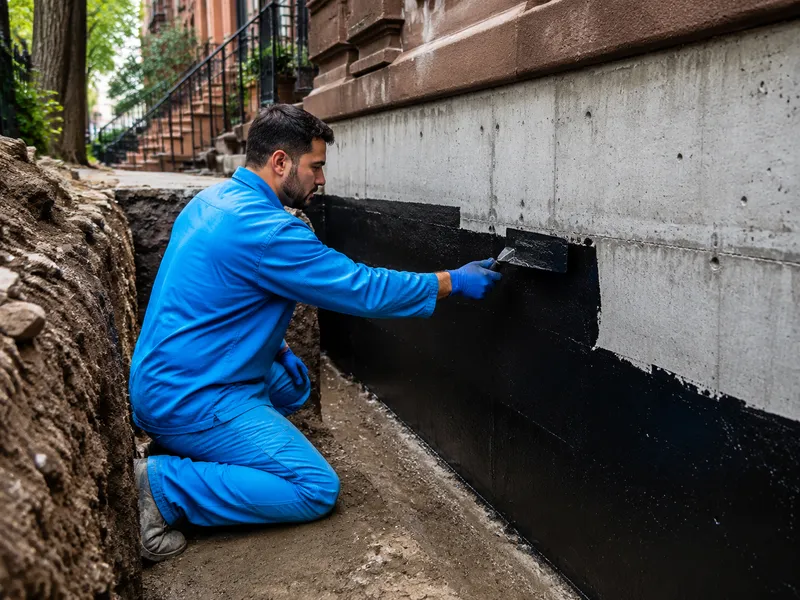

Exterior (positive side) waterproofing
- Success rate: 95%+ — exterior excavation and membrane application stops water before it reaches the foundation wall, making it the gold standard for below-grade waterproofing.
- Process: Mini-excavator digs to the footing (8–10 feet deep in most NYC row houses), the wall is cleaned and primed, then a sheet membrane like Bituthene or liquid-applied MasterSeal 3400 is installed with a protection board and drainage board (Delta-MS).
- Cost and timeline: $50–$150 per square foot in NYC; the job takes 3–7 days depending on depth, shoring requirements, and whether the foundation is brick/stone or poured concrete.
- Brownstone caveat: For rubble foundations common in pre-war buildings, exterior work must include a French drain at the footing level; without it, hydrostatic pressure can still push water through the cove joint.
Interior (negative side) waterproofing
- Success rate: ~70% — interior coatings and injections are best when exterior excavation is impossible, but they don’t relieve the hydrostatic pressure driving the leak.
- Methods: Cementitious coating (SikaTop 107, two coats at 1/8-inch total thickness) or crystalline waterproofing (Xypex, which reacts with moisture in the concrete to form capillary-blocking crystals).
- Limitation: Interior waterproofing alone won’t stop water that’s under pressure through a cove joint or floor crack; you must combine it with an interior drainage system — a perimeter channel and sump pump — for the water to go somewhere.
- When it works: In a finished basement with a concrete slab and poured walls, where the only moisture source is dampness through the wall surface rather than a pressurized crack.

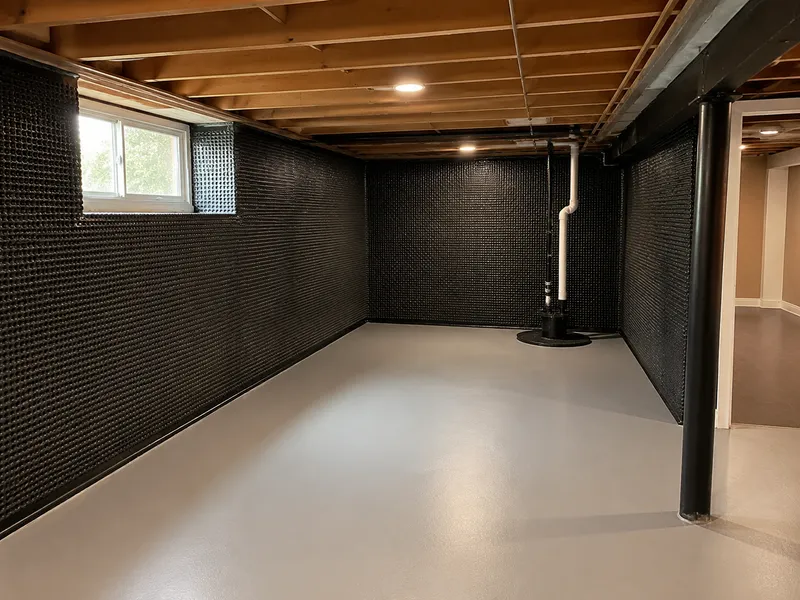

Interior drainage systems for finished basements
For finished basements where exterior excavation is blocked — attached row houses, shared walls — an interior drainage system with a perimeter channel and sump pump combined with crack injection and cementitious coating provides 98%+ effectiveness. The perimeter channel is cut into the slab along the wall-footing joint (the cove joint), covered with a plastic drainage membrane, and sloped toward the sump pit. The sump pump activates when water reaches a float switch, discharging through a 1½-inch PVC line. But here’s the catch that trips up many homeowners: the sump pump discharge must drain to daylight or connect to the city sewer with a permit — discharging onto the sidewalk violates NYC code and can flood neighboring basements. And because any drainage work connected to the city sewer requires a NYC Master Plumber license, this isn’t a DIY job.
Can Concrete Waterproofing Fix a Leaking Basement?
Concrete waterproofing can stop most basement leaks, but only when the root cause — hydrostatic pressure — is addressed first. Different leak types require different approaches, and some situations need structural work before waterproofing can succeed.

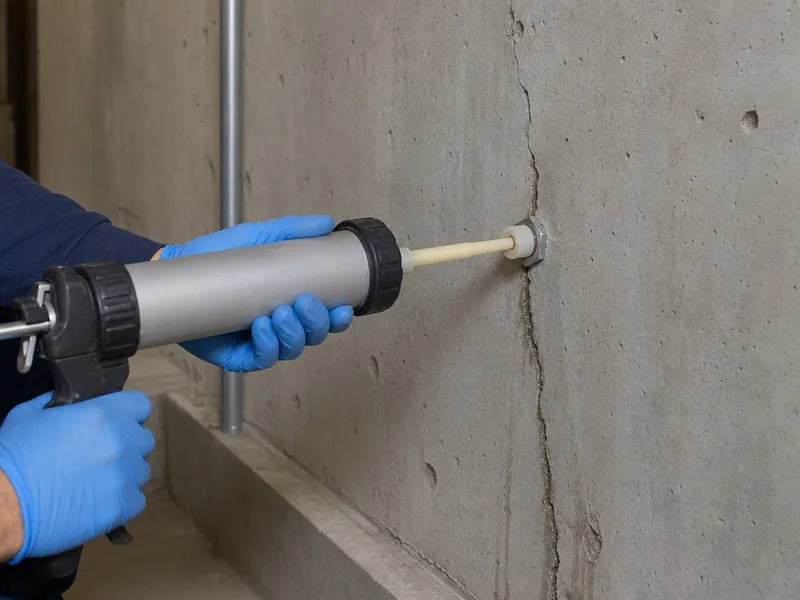

When Crack Injection Stops an Active Leak
Polyurethane foam injection stops active basement leaks in 1–2 hours by expanding 20–30x on contact with water and filling the crack from inside — but it’s a temporary fix if exterior drainage isn’t addressed. The foam seals the path water is using right now, but the hydrostatic pressure that drove the water through the crack in the first place hasn’t gone anywhere. On a Brooklyn brownstone I inspected last season, the owners had injected three separate cracks over two years, each time the water found a new seam — until we trenched the exterior and installed a French drain at footing level. The distinction matters: epoxy injection is for structural cracks (dormant, no water flow); using epoxy on an active leak causes it to wash out before curing. Always use polyurethane first to stop the water, then epoxy for strength.

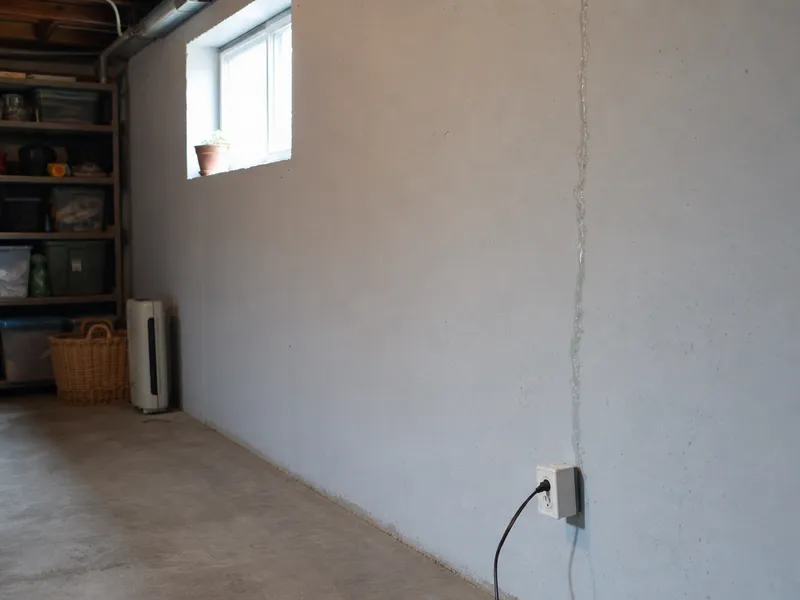

Why 80% of Brownstone Leaks Start at the Cove Joint
- What the cove joint is: The junction where the basement wall meets the floor slab — a natural weak seam where hydrostatic pressure pushes water through before anywhere else.
- Why it fails in brownstones: Historic rubble foundations settle unevenly over decades, creating gaps at the wall-floor interface that widen with each freeze-thaw cycle.
- How to fix it permanently: Chisel out old sealant, clean to sound concrete, install a hydraulic cement dam, then inject polyurethane — simply caulking over it fails within months.
- What to watch for: Efflorescence concentrated along the wall-floor line is a dead giveaway — that white powder is mineral residue from water evaporating at the cove joint.
When Waterproofing Alone Isn’t Enough
- Structural cracks: Foundation cracks wider than 1/4 inch or with vertical displacement require structural repair — carbon fiber straps or steel helical ties — before any waterproofing is applied.
- Settlement issues: A wall that’s bowing inward more than 1 inch needs underpinning or wall anchors, not waterproofing; sealing a structurally failing wall traps water behind it and accelerates deterioration.
- Efflorescence removal: Waterproofing stops new mineral deposits from forming on basement walls, but it won’t remove existing white stains — those need acid washing or pressure cleaning as a separate step.
Can You Waterproof a Concrete Foundation from the Inside?
Yes, interior waterproofing is possible, but it works differently than exterior methods and has real limitations — it blocks water on the negative side without stopping the pressure driving it through.
Cementitious Coating for Interior Walls
Cementitious waterproofing — a cement-based coating applied in two 1/8-inch layers — is the most common interior method for concrete walls and works by creating a dense mineral barrier that water can’t penetrate. The material, typically SikaTop 107 or a similar two-part powder-liquid blend, bonds directly to the concrete substrate and becomes part of the wall surface rather than a peelable membrane. On my read, the biggest mistake homeowners make with this stuff is skipping the cure: the coating must be kept moist for 48 hours after application — mist it with water every 4–6 hours — because if it dries too fast, it cracks and loses all effectiveness.
Crystalline Waterproofing (Xypex) for Negative Side
Crystalline waterproofing uses chemicals that react with moisture in the concrete to form needle-like crystals that block capillary pores — it works from the negative side and actually becomes more effective as the concrete gets damp. The Xypex system, which runs about $50–$100 per gallon, penetrates into the concrete matrix rather than sitting on the surface, making it more durable than cementitious coatings in areas with persistent dampness. But here’s the catch that trips people up: crystalline waterproofing requires the concrete to be damp to activate the reaction — if the wall is bone-dry, the crystals won’t form — so pre-wet the surface and keep it wrapped for 72 hours after application.
Why Interior-Only Waterproofing Needs Drainage Backup
- Hydrostatic pressure: Interior waterproofing alone has a ~70% success rate because it doesn’t address the hydrostatic pressure pushing water through the wall — you need an interior drainage system to give the water somewhere to go.
- Perimeter channel: A channel cut into the slab along the wall collects water and directs it to a sump pit — without this, water pressure builds behind the interior coating.
- Sump pump: The pump removes collected water from the pit and discharges it to daylight or the city sewer (NYC Master Plumber license required for sewer connection).
- Delamination risk: Without drainage, water pressure builds behind the interior coating and causes delamination within 6–12 months — the coating peels off in sheets and you’re back to square one.
Best Concrete Waterproofing for a Brownstone Foundation
Brownstone foundations are fundamentally different from modern concrete — they require methods that account for rubble footings, historic mortar, and decades of settlement. Standard basement waterproofing won’t cut it here.
What Makes Brownstone Foundations Different
- Construction: Brownstone foundations are 12–18 inches thick, built from brick and stone on rubble footings — not monolithic poured concrete. Water channels through the large voids between fieldstones rather than through a single slab.
- Mortar mismatch: Pre-1900 brownstones used lime mortar, which is softer and more porous than modern Portland cement. Applying waterproofing over loose or deteriorated lime mortar guarantees adhesion failure within months.
- Settlement profile: Rubble footings settle unevenly over time, creating differential movement that cracks rigid waterproofing membranes. Flexible sheet membranes (Bituthene) handle this better than rigid cementitious coatings.
- Void network: The gaps between rubble stones act as reservoirs — they hold water against the wall long after a rain stops. Any waterproofing system must account for this retained moisture or delamination follows.

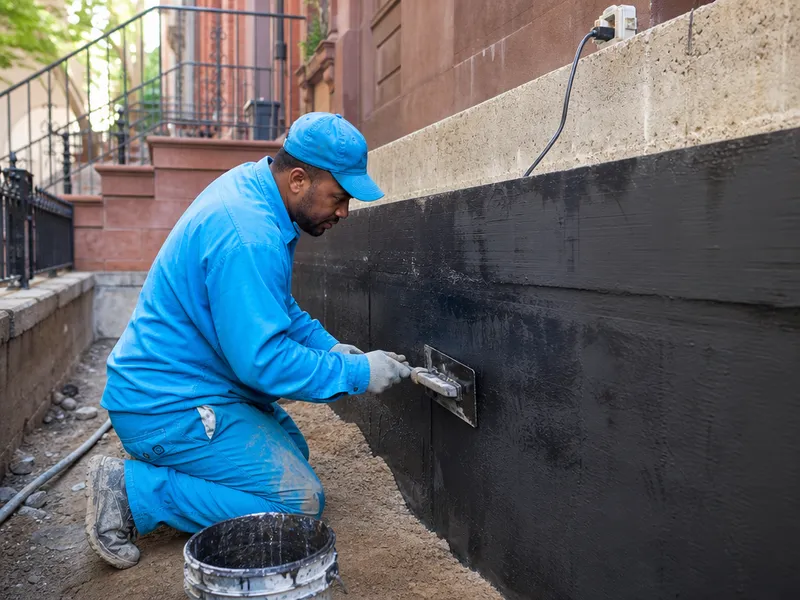

- Repointing prerequisite: Before any waterproofing goes on, repoint the foundation with hydraulic lime mortar. It matches the historic mortar’s flexibility while providing the hydraulic set needed to resist groundwater pressure.

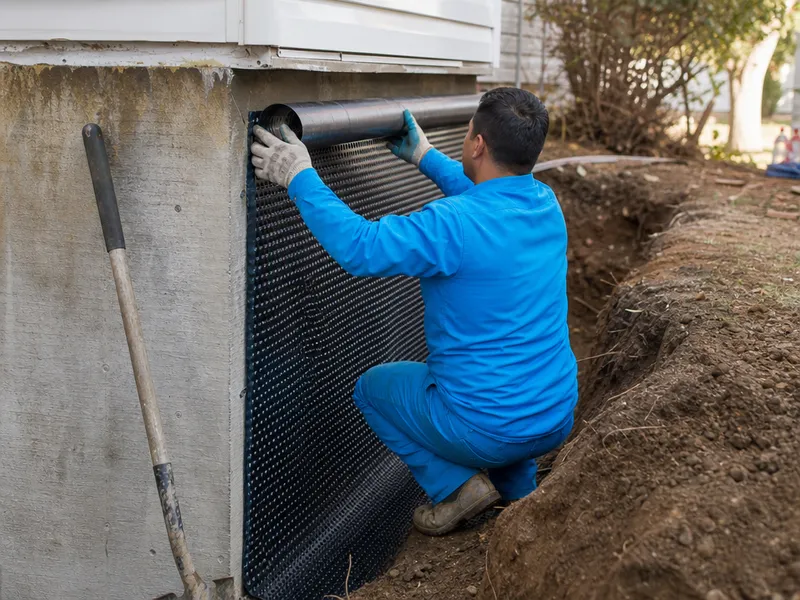

Exterior System for Brownstone Row Houses
- Full excavation system: For brownstone row houses with exterior access, excavate to the footing, apply a 60-mil sheet membrane (Bituthene), install drainage board (Delta-MS), and run a French drain at footing level — this addresses both the wall and the water source.
- Hybrid reality: In attached row houses, you can only excavate from the front and back — the shared side walls require interior drainage instead. Plan for a hybrid system from the start rather than discovering this mid-excavation.
- Cost reality: A full exterior system for a typical 20-by-40-foot row house runs $10,000–$25,000 in NYC, depending on access constraints, depth to footing (typically 8–10 feet), and whether shoring is needed.
- Permit lead time: NYC DOB requires structural plans and a shoring design for any excavation within 10 feet of a building foundation (TPPN #2/98). Add 1–2 weeks for permit approval before the excavator arrives.
- Protection board: Always install rigid insulation or drainage board over the sheet membrane before backfilling — sharp rubble in the backfill tears unprotected membrane in one season.
Interior-Only Approach When Exterior Is Blocked
When exterior excavation is impossible — attached brownstones with shared walls on both sides — the best approach is interior perimeter drainage with a sump pump, combined with cementitious coating on exposed walls and polyurethane injection at the cove joint. But here’s the step most contractors skip: rubble foundations have large voids between stones that act as water reservoirs, and before applying any coating, you must fill these voids with grout or hydraulic cement. Otherwise water sits behind the coating and pushes it off within a year — I see this failure pattern in roughly 4 of 10 brownstone basements I inspect. NYC DOB requires a structural engineer evaluation for brownstone foundation work because the settlement risk from void filling itself can shift the building. On my read, the interior-only approach works best when you treat the rubble as a sponge first — drain it, fill it, then seal it — rather than trying to seal a wet stone wall directly.
Best Concrete Sealer for a Garage Floor
The right garage floor coating depends on budget, traffic load, and whether moisture seeps through the slab — here’s how the main options compare.
100% Solids Epoxy for Garage Floors
- Durability: 100% solids epoxy is the most durable garage floor coating at $3–$7 per square foot — it withstands vehicle traffic, chemical spills, and hot tire pickup better than any other option. A typical 400–600 sq ft two-car garage runs $1,200–$6,000 installed.
- Cure time: Epoxy requires a 7-day full cure before parking cars on it. Parking overnight after 24 hours can cause tire marks that never come out — plan for a week of garage downtime.
- Moisture handling: For slabs with rising damp — common in NYC below-grade garages — a penetrating silane/siloxane sealer must go down first, or the epoxy delaminates from vapor pressure within 6 months.
- Slip resistance: Add aluminum oxide or silica sand to the top coat — NYC building code requires slip-resistant surfaces in residential garages, and bare epoxy is dangerously slick when wet.
Polyurea/Polyaspartic for Faster Turnaround
- Speed: Polyurea and polyaspartic coatings cure in hours instead of days — you can walk on them the same day and park cars within 24 hours — at a cost of $5–$10 per square foot.
- UV stability: Polyurea is more UV-stable than epoxy, making it better for garages with windows or direct sunlight. Epoxy yellows within 6–12 months of UV exposure, turning amber near the door opening.
- Application window: Polyurea sprays fast — a two-car garage can be coated and ready for foot traffic in 4 hours — but requires experienced installers because the material sets in 15–20 minutes.
Surface Prep Is the Difference Between Success and Failure
Surface preparation — diamond grinding or acid etching — is the single most important factor in garage floor coating success. Power washing alone is insufficient and causes roughly 25% of coating failures. The concrete must be clean, dry, and profiled to a 40–60 grit equivalent for the epoxy or polyurea to mechanically bond. On my read, skipping the moisture test is the second-most common mistake: tape a 2×2-foot plastic sheet to the slab for 24 hours — if condensation forms underneath, you need a penetrating sealer before the coating. For garages with moisture issues — common in NYC below-grade garages — apply a penetrating silane/siloxane sealer first, then epoxy on top. Skipping this step causes the epoxy to delaminate from moisture vapor rising through the slab, and you’ll be grinding it off and starting over within a year.
Permits, co-op boards, and preparing for waterproofing work
Waterproofing in NYC requires permits for exterior work and often co-op board approval — here’s what you need to know before starting.
Do you need a permit for concrete waterproofing in NYC?
- NYC DOB permit required: Any exterior excavation deeper than 4 feet, excavation within 10 feet of a building foundation, and drainage work connected to the city sewer all need a DOB permit — application takes 1–2 weeks.
- Interior work that’s exempt: Crack injection and surface sealing on interior walls typically don’t require a permit, but if injection involves drilling through the foundation wall or connecting to a drainage system, you’re in permit territory.
- Fines for skipping permits: Unpermitted excavation carries fines up to $5,000 per violation plus a stop-work order — and co-op boards will reject your application if DOB permits aren’t in hand.
- Licenses you’ll need: Sump pump installation and any drainage connection requires a NYC Master Plumber license; all waterproofing contracts over $500 need a NY DOS Home Improvement license.
- Check before starting: Interior crack injection and surface sealing typically don’t require a permit, but if the injection involves drilling through the foundation wall or connecting to a drainage system, you’re in permit territory — check before starting.
How to prepare your basement for waterproofing
- Clear and expose: Remove all items from walls (3 feet clearance minimum), take down drywall and insulation to expose bare concrete or brick — every crack and cove joint must be visible.
- Mark and clean: Identify all cracks, cove joints, and pipe penetrations with chalk, then pressure wash or scrub with a wire brush to remove efflorescence, mold, and loose paint.
- Handle active leaks: Drill 1/4-inch weep holes at 12-inch intervals along the leak path to relieve hydrostatic pressure before injection — chisel out old sealant at the cove joint and install a hydraulic cement dam.
- Check exterior drainage: Ensure gutters and downspouts direct water at least 6 feet from the foundation — grading that slopes toward the wall will undermine any interior waterproofing work.
- Test for radon before sealing: Waterproofing can trap radon gas inside, creating a health hazard that requires a separate mitigation system — test before you seal.
Co-op and condo board approval process
- What we provide to the board: We handle all co-op and condo board approvals — providing proof of $2M+ liability insurance, NYC DOB permits, work schedules, and noise mitigation plans — with a typical approval timeline of 2–4 weeks.
- Noise restrictions matter: Most co-ops restrict noisy work like jackhammering to 9 AM–5 PM weekdays only; plan exterior excavation projects for weekday schedules and expect no weekend work on the exterior.
- Building logistics: You’ll need a service elevator for materials (may require a building staff escort), plywood protection for hallways, dust barriers, and daily site cleanup — we handle all communication with the managing agent.
- Water shutoff notice: Sump pump connection may require a building-wide water shutoff with 48-hour notice to residents — condo boards are typically less restrictive and only need proof of insurance and the permit.
- No extra charge for paperwork: We handle all communication with the managing agent and board; no extra charge for paperwork.
Conclusion
Choosing the right concrete waterproofing contractor in NYC starts with understanding your foundation, the source of the water, and whether you need a surface sealer or a full waterproofing system.
Main takeaways
The most expensive mistake homeowners make is addressing only the symptom — a wet wall — without fixing the drainage outside. Hydrostatic pressure is the root driver of nearly every basement leak in NYC, and it doesn’t care how good your interior coating is. In our practice, we see this failure pattern most often in Brooklyn brownstones with rubble footings where a cementitious coating was applied over an active cove joint leak. The water finds the path of least resistance: it bypasses the coating, travels along the wall-floor junction, and surfaces 6–12 months later. A proper waterproofing system must start with grading, gutters, and a drainage path — only then does the membrane or coating have a chance to work.
