Permits and Regulations for Duct Installation in NYC
NYC DOB permits are required for new duct installation or major modifications, with exemptions for minor repairs. Here’s what you need to know before starting any duct work in the five boroughs.
When is a NYC DOB permit required for duct work?
We file NYC DOB permits for all new duct installation and major modifications — including when you change HVAC system capacity or add new supply runs. The permit requirement kicks in any time ductwork is extended beyond existing runs, rerouted through new wall cavities, or connected to a different air handler. Residential permit fees run $150–$500 at filing; commercial jobs cost $500–$2,000, and both require load calculations per ACCA Manual J along with duct layout drawings. Unpermitted work carries fines between $2,500 and $10,000 per violation, plus the DOB can issue a stop-work order that stalls the entire project. Minor repairs like replacing 6 feet or less of existing ductwork typically don’t need a permit, but any new duct routing through fire-rated walls triggers fire damper requirements that must be inspected.
What does the permit process involve in NYC?
- Load calculations & plans: We submit Manual J load calculations, duct layout drawings showing all supply and return runs, and a signed plan — residential jobs use our licensed contractor’s stamp, while commercial requires a PE seal.
- Filing & fees: The DOB filing fee runs $150–$500 for residential, $500–$2,000 for commercial; expediter fees add $500–$1,500 if you need faster turnaround.
- Rough-in inspection: The DOB inspects duct sealing and insulation at rough-in, before drywall goes up — scheduling inspection windows correctly saves weeks of delays.
- Final sign-off: After completion, a leakage test per NYC Energy Code (≤5% for new construction) must be documented for permit closure.
Permit cost and fines for unpermitted duct work
| Item | Residential | Commercial |
|---|---|---|
| DOB filing fee | $150–$500 | $500–$2,000 |
| Expediter fee (optional) | $500–$1,500 | $1,000–$3,000 |
| Fine for unpermitted work | $2,500–$10,000 | $5,000–$10,000 |
| Stop-work order risk | Yes | Yes |
| Leakage test requirement | ≤5% total airflow | ≤5% total airflow |
Can you install ducts in an older building?
Duct installation in pre-war buildings, brownstones, and older multi-family buildings is routine — we use specific strategies for tight spaces and structural constraints.
How do you route ducts in pre-war buildings and brownstones?
We use low-profile 4″×10″ rectangular sheet metal duct in pre-war buildings with 6″–8″ ceiling plenums, routing around cast-iron stacks and brick walls. This profile fits between joists where standard 8″ round duct won’t clear. In Brooklyn brownstones, existing chimney chases often provide the only vertical path for duct runs — we line them with smooth sheet metal to maintain airflow and meet fire code. For lath-and-plaster party walls, we surface-mount duct in basements rather than chase through finished spaces, preserving the original structure.
Asbestos and structural challenges in older NYC buildings
- Asbestos testing: We test existing duct insulation before any modification — pre-1980 buildings may have asbestos-containing materials that require licensed abatement.
- Cast-iron stacks: These waste pipes run through multiple floors and block straight duct paths; we use offset fittings to route around them.
- Lath-and-plaster walls: Opening these for duct chases is destructive and costly, so we surface-mount duct in unfinished basements and closets instead.
- Limited ceiling plenums: Pre-war buildings often have 6″–8″ between joists and finished ceiling — low-profile rectangular duct (4″×10″) clears this gap where round duct won’t.
- Fire-rated penetrations: Running duct through party walls requires fire dampers at each penetration per NYC Building Code — we install them during rough-in.
How do you choose the right duct size and material?
Duct sizing follows ACCA Manual D, and material choice depends on building type, space constraints, and budget — here is what matters for NYC apartments and brownstones.
Duct sizing per ACCA Manual D: CFM, static pressure, and friction loss
We size ducts using ACCA Manual D — starting with a Manual J load calculation to determine CFM per room, then matching duct diameter to available static pressure (target 0.5″–0.8″ w.c.). A standard 3-ton system moves 1,200 CFM total; each 6″ round supply delivers 100–150 CFM, an 8″ round handles 200–250 CFM, and a 12″×6″ rectangular trunk carries 400–500 CFM. The friction loss rate we design for is 0.08″–0.10″ w.c. per 100 feet. In our practice, we measure static pressure at the air handler plenum first, subtract pressure drops from the coil, filter, and registers, and the remainder — typically 0.3″–0.5″ w.c. — is available for the ductwork. Undersized ducts in NYC apartments push static pressure above 1.0″ w.c., causing short-cycling and premature compressor failure — oversized ducts waste energy through low velocity and poor air mixing.
Best duct material for NYC apartments: sheet metal vs flexible vs duct board
| Material | Share of NYC jobs | Cost per linear foot | Friction loss | Best use case |
|---|---|---|---|---|
| Sheet metal (galvanized steel) | 70% | $2–$4 | Lowest — 0.08″ w.c./100 ft | New construction, tight ceiling plenums, multi-family fire-rated runs |

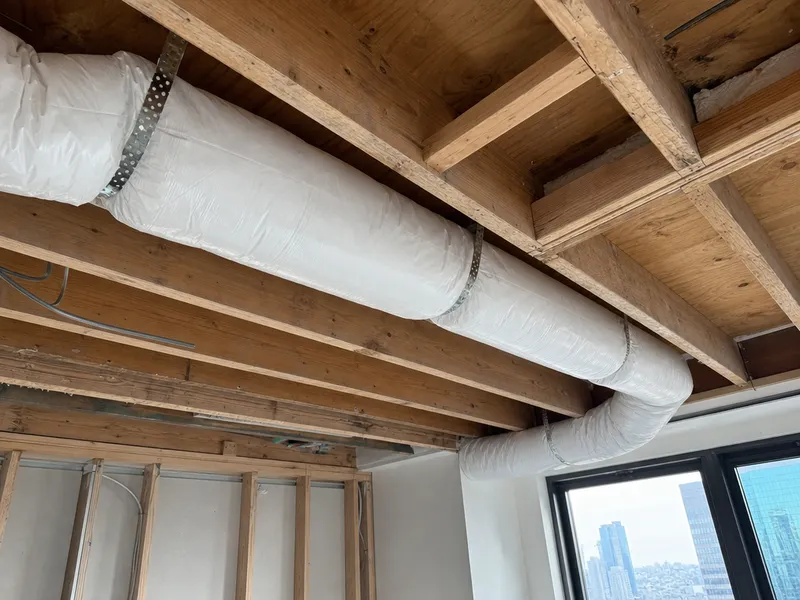

| Flexible duct (aluminum/PVC-lined) | 20% | $0.50–$1.50 | Higher — 0.10″–0.12″ w.c./100 ft | Retrofits in tight chases, short runs ≤6′ per code |

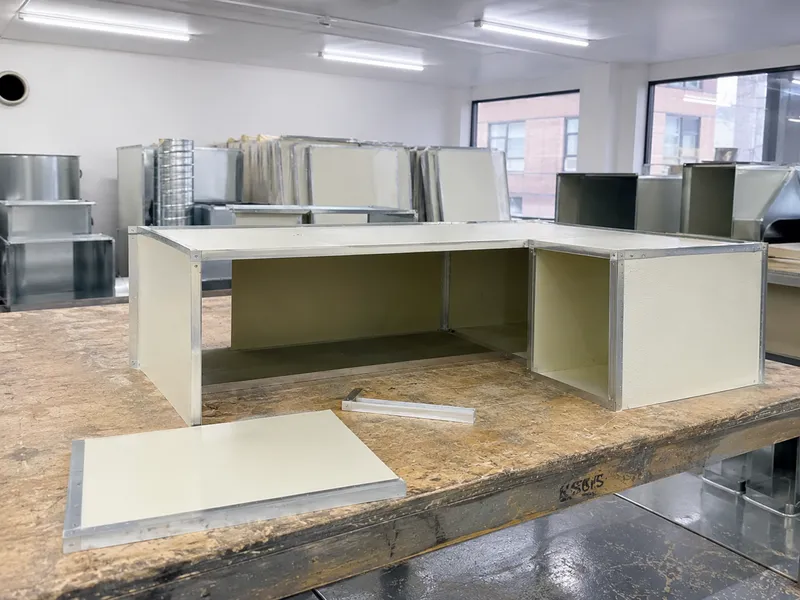

| Duct board (fiberglass) | 10% | $1.50–$3 | Moderate — 0.09″ w.c./100 ft | Basements, crawlspaces where noise reduction matters |
Common NYC duct sizing mistakes and how to avoid them
- Undersized return air: The most common mistake — supply ducts sized correctly but returns too small, causing negative pressure and drafts. Pre-war buildings with original 4″×8″ returns can’t handle modern 3-ton systems; we typically double return size or add a second return path to balance airflow.
- Flexible duct kinked at corners: Installers often pull flex duct too tight around turns. Must maintain a 4″ minimum bend radius per manufacturer specs — otherwise the liner collapses, cutting CFM by 30–50% at that branch.
- Duct tape on joints: Standard duct tape degrades in 1–2 years. We seal every joint with mastic or foil tape — mastic on sheet metal, foil tape on flex duct connections. A smoke-pencil test after sealing catches any remaining leaks.
Can you install ducts for a new HVAC system?
Yes, we install ductwork for new furnaces, air conditioners, heat pumps, and packaged units, with duct sizing matched to the equipment and full NYC Energy Code compliance.
Matching ductwork to your new HVAC system’s CFM requirements
Eco Service NY sizes ductwork to match your new system’s CFM rating—oversized ducts cause low velocity and poor mixing, while undersized ducts create high static pressure and short cycling. For a 3-ton central AC delivering 1,200 CFM, we size the main trunk at 12″×6″ rectangular or 14″ round sheet metal, with 6″ round branches at 100–150 CFM per room. On a recent Brooklyn brownstone heat-pump install, the existing 8″ returns were undersized for the new 4-ton Mitsubishi hyper-heat unit—we upsized them to 10″ round and added a second return in the hallway to balance static pressure at 0.65″ w.c. Installing motorized dampers during duct rough-in for zoning reduces energy waste by 20–30% and lets you control temperature independently per floor or room.
Energy code compliance for new duct systems in NYC
- Duct leakage limit: New duct systems must meet ≤5% leakage per NYC Energy Code 2025—we seal all joints with mastic (not duct tape) and test with a duct blaster before drywall goes up.

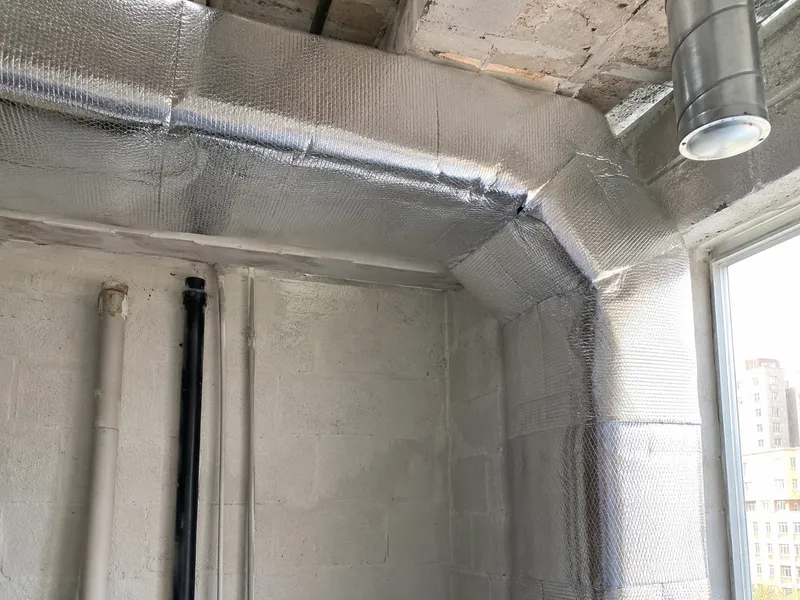

- Insulation requirement: Ducts in unconditioned spaces like attics and crawlspaces require R-6 insulation—we wrap with foil-faced fiberglass and seal the vapor barrier with UL-181 tape.
- Filter minimum: MERV-8 filters are required for new construction; we install a 4″ media cabinet at the return plenum to accommodate higher-grade filtration without excessive pressure drop.
- Documentation for DOB: The duct leakage test report must be filed with the NYC DOB for permit sign-off—we include this in our project package and coordinate with the inspector during rough-in walk-through.
Do you install ducts for commercial kitchens?
We install commercial kitchen ductwork across NYC — grease ducts, exhaust hood ducts, and makeup air ducts built to fire-rated specifications and NYC Mechanical Code standards.
Grease duct and fire damper requirements for NYC commercial kitchens
We install welded steel grease ducts per NYC Mechanical Code Chapter 5 — minimum 16-gauge steel with continuous slope to the grease trap, fire-rated enclosure, and access doors every 20 feet for inspection and cleaning. Fire dampers at duct penetrations through fire-rated walls must carry fusible links rated at 165°F, with accessible inspection doors on both sides of the wall. The duct itself requires a 1-hour fire-rated shaft enclosure when passing through multiple floors — common in Manhattan restaurant spaces where the kitchen sits on the ground floor and the exhaust fan lives on the roof. For Type I hoods (grease-producing cooking), the entire duct run must be welded steel with no screws or rivets inside the airstream where grease can accumulate. Fire dampers missing their fusible links or inspection doors trigger FDNY violations and can shut down your kitchen — we verify every damper during installation.
Permits and FDNY approval for commercial kitchen duct work
- NYC DOB permit: Required for all new commercial kitchen duct installation — we file the permit with load calculations, duct layout drawings, and signed plans by a licensed professional engineer.
- FDNY approval: Grease ducts require FDNY sign-off; we coordinate the fire suppression system tie-in and schedule the joint DOB/FDNY inspection.
- Cleaning access standard: NYC Fire Code mandates duct cleaning every 3 months for Type I hoods — we install access doors at every change of direction and every 20 feet so the cleaning crew can reach every section.
- Makeup air duct: Required to replace exhausted air at 80–90% of the exhaust CFM; we size it to prevent negative pressure that pulls kitchen fumes into the dining area.
- Fire suppression tie-in: The exhaust hood fire suppression system (Ansul or similar) must connect to the duct and automatically shut down the exhaust fan on activation — we coordinate with the suppression contractor for code-compliant integration.
Duct Installation in NYC: Key Takeaways
Proper duct installation in NYC requires the right permits, correct sizing per ACCA Manual D, and material selection that matches your building type.
Main takeaways
Proper duct installation in NYC demands the right permits, sizing per ACCA Manual D, and material selection matching your building type — pre-war brownstone or modern high-rise. Sheet metal accounts for 70% of jobs here: low friction loss (0.08″ w.c./100 ft), fire-rated, and durable enough for tight ceiling plenums. Flexible duct handles the other 20%, mainly retrofit work in chases and between floors, but its higher friction requires oversizing by 1″ diameter versus sheet metal. Duct board rounds out the mix for basement noise-sensitive spaces. The difference between a system running efficiently for 20 years and one failing in 5 often comes down to sealing quality and static pressure management during installation.
